Many clients place an order and then wait – without knowing where their order sits in the process, how much time remains, or what they will be updated on. This article walks through every production stage at Tram Anh Caps, the realistic time each takes, and what you can expect at each milestone.

Tram Anh Caps production process – from design file to finished cap
Tram Anh Caps factory – the entire process from raw material to finished product happens on-site, with no outsourcing

How is this different from the article on production timelines? The article on how long cap production takes answers “how many days and what to do to avoid delays.” This article goes deeper: what each specific stage at Tram Anh Caps involves, who handles it, and when you will be notified.

Overview: 7 stages from file to delivery

Production at Tram Anh Caps moves through 7 main stages. Total time depends on order quantity, design complexity, and current fabric stock availability. For a standard order (300–1,000 pieces, design already finalized), the total typically runs 15–25 working days.

StageWhat happensRealistic timeframe
1. Brief review & requirements checkReading the brief, verifying design files, confirming technical specs1–2 working days
2. Quote & contractIssuing detailed quote, aligning on terms, confirming the order1–3 working days
3. Material preparationPulling fabric, thread, hardware from stock – or placing orders if needed1–3 days (in stock) / 5–7 days (special order)
4. Sample production & approvalMaking 1–3 physical samples, client review, revisions if needed3–7 days (depending on revision rounds)
5. Mass productionFabric cutting, embroidery/printing, sewing, hardware finishing5–10 days (depending on quantity)
6. Quality control (QC)100% finished goods inspection before packing1–2 days
7. Packing & deliveryPacking to spec, arranging transport or warehouse pickup1 day

Stage 1: Brief review and requirements check

After receiving a client’s brief, the first step is not to issue a quote – it is to read the full brief carefully and verify the design files. This is the step many factories skip in order to quote faster, but it is the most important stage for preventing misunderstandings later.

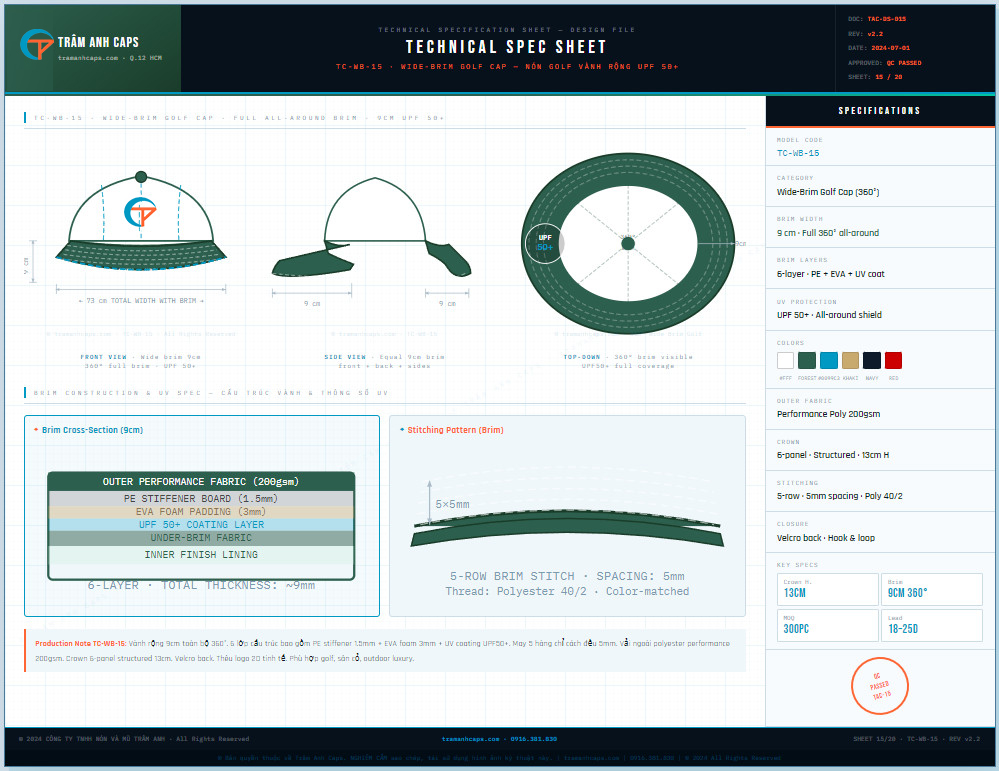

Technical specifications for cap design
Technical specifications for cap design

What is checked at this stage: is the logo file in vector format (AI, CDR, EPS), are colors provided as Pantone or CMYK codes, are logo dimensions stated in explicit measurements, is the placement position clearly specified. If any specification is missing, the account team follows up for clarification before proceeding.

Technical specifications for baseball cap
Technical specifications for baseball cap

Stage 2: Quote and contract confirmation

A Tram Anh Caps quote is not a single number. The quote document specifies: unit price across quantity tiers, exact fabric type and weight in g/m², decoration method, estimated production timeline, and delivery terms. There are no hidden costs introduced after confirmation.

Once both sides agree on the quote, a contract is signed covering quantity, materials, quality standards, delivery date, and the process for handling defective goods. The client pays a deposit so the factory can begin material preparation.

Stage 3: Material preparation

Samsung kaki fabric stock at Tram Anh Caps – available stock reduces production lead time
Samsung kaki fabric warehouse – in-stock materials allow production to start 5–7 days faster than sourcing special orders

For common materials and colors – black, navy, and white Samsung kaki – stock is typically available and fabric cutting can begin immediately after sample approval. For special colors or less common materials, sourcing time adds 5–7 days.

This is why confirming your fabric color early in the discussion directly affects total production time. An order can save an entire week simply because the client chose an in-stock color rather than a special-order one.

Stage 4: Sample production and approval

Embroidery machines at Tram Anh Caps producing pre-production samples for client approval
Sample production on the Tajima embroidery line – logos embroidered on the actual production fabric before mass production begins

This is the most important stage, and the one clients most often want to skip to save time. But a mistake identified here costs 2–3 days to correct. The same mistake discovered after the full batch is complete can cost 2–3 weeks and significant rework expense.

Tram Anh Caps produces 1–3 physical samples depending on order complexity. Samples are made using the exact fabric and embroidery thread or ink that will be used in production – not simplified stand-ins. Sample photos are taken in natural outdoor light and sent with a scale reference so clients can assess color and dimensions accurately.

Client approval of samples is confirmed in writing by email – not only via messaging app. This is important: written sample approval is the legal basis for proceeding with mass production and serves as clear documentation if any dispute arises later.

Stage 5: Mass production

Once the sample is approved, mass production begins. The in-factory process moves through these steps in sequence:

  • Fabric cutting: All fabric is cut from a single lot to ensure color consistency across the full batch. Cut pieces are measured before moving to the next stage
  • Embroidery or printing: Logo embroidery or printing is applied according to the agreed method. This is the most time-intensive stage – embroidery machines process one cap at a time, and this cannot be parallelized for large quantities
  • Sewing and assembly: Fabric panels are sewn in sequence, with the crown, brim, lining, and closure hardware assembled and attached
  • Finishing: Excess threads trimmed, caps shaped, each piece given a final check before passing to QC
In-house fabric weaving at Tram Anh Caps – raw material control for consistent batch color
In-house weaving facility – controlling input material quality ensures consistent color across the full production batch
Full in-house production line at Tram Anh Caps – cutting to finished product in one facility
Full in-house production line – fabric cutting through sewing completion, all in one facility

Stage 6: Quality control

QC at Tram Anh Caps is not a single end-of-line check. It operates in two layers:

Mid-production QC: For every 50–100 completed pieces, the QC team randomly checks 5–10 items for embroidery color, logo placement, and stitching quality. If a deviation is found, production pauses for adjustment before continuing – rather than continuing to accumulate defective pieces that then all need rework.

Final QC: 100% of finished goods are inspected before packing. The checklist covers: logo color and sharpness, logo position (measured with a ruler), stitching quality (no loose threads, no fabric puckering), closure hardware finish, and quantity matching the contract.

Finished cap quality inspection at Tram Anh Caps before packing
100% finished goods inspection before packing – no defective product leaves the factory

Stage 7: Packing and delivery

Packing follows the client’s specified requirements – individual PE bags, rigid box packaging, or bulk cartons with a defined quantity per box. For corporate gift or event orders, more careful packing is typically required to prevent deformation during transit.

Before goods leave the warehouse, photos of all packed cartons are taken and sent to the client with the confirmed piece count per box – so the client can cross-check quantities at the point of receiving.

Factors that actually affect total production time

There is no fixed number that applies to every order. These are the factors that most significantly affect the total timeline:

  • Fabric color in stock vs special order: 5–7 day difference. Choosing an in-stock color is the simplest way to shorten lead time
  • Number of sample revision rounds: Each additional round adds 2–3 days. Providing clear technical files from the start typically reduces this to one round
  • Order quantity: 300 pieces vs 3,000 pieces adds roughly 5–8 days of pure production time
  • Embroidery complexity: Multi-color logos, fine detail, or multiple embroidery positions per cap take significantly more machine time
  • Time of year: October through December (year-end event season) and the period before Lunar New Year carry heavier order volumes – placing orders 1–2 weeks earlier than usual is advisable during these periods

What clients are notified of, and when

Transparent communication about progress is part of the service, not something you should need to ask for. The standard update schedule at Tram Anh Caps includes:

  • Order receipt confirmation and estimated production timeline – within 24 hours of contract signing
  • Physical sample photos sent for review – before mass production begins
  • Confirmation that mass production has started after sample approval
  • Mid-production progress update – for large orders or upon request
  • Pre-packing photos of finished goods – for client final confirmation
  • Dispatch notification with shipping details

You should not need to ask “where is my order right now” – that information is proactively sent at each significant milestone. This approach to transparency is part of what is discussed in the case study on why major brands choose long-term partnerships with Tram Anh Caps.

If you would like to visit the factory or see the process firsthand, see: What is a direct cap manufacturer and why work directly with the factory.


Want to know how long your order will take?

Send your quantity, material preference, and deadline – receive a production timeline estimate and detailed quote within 24 hours.
